Cellular Manufacturing Scheduling: How Dedicated Cells Change Your Scheduling Approach

Most manufacturers think of scheduling as a single unified problem: given a list of jobs and a pool of machines, decide what runs where and when. When you convert a functional shop to cellular manufacturing, you discover that this framing no longer fits. A cell is not just a collection of machines — it's a mini-factory within the factory, with its own logic, its own scheduling rhythm, and its own set of constraints.
Understanding how cellular manufacturing changes the scheduling problem is essential for both designing cells that work and running them effectively once they're built. After 35 years of helping manufacturers model and schedule complex facilities, User Solutions has seen the full range of cellular implementations — cells that transformed scheduling simplicity, and cells that made it worse because the scheduling model didn't keep up with the layout change.
This post covers what a manufacturing cell is, how scheduling within a cell fundamentally differs from functional layout scheduling, and the decision framework for designing a cellular layout that actually improves your planning.
What a Manufacturing Cell Is (and Isn't)

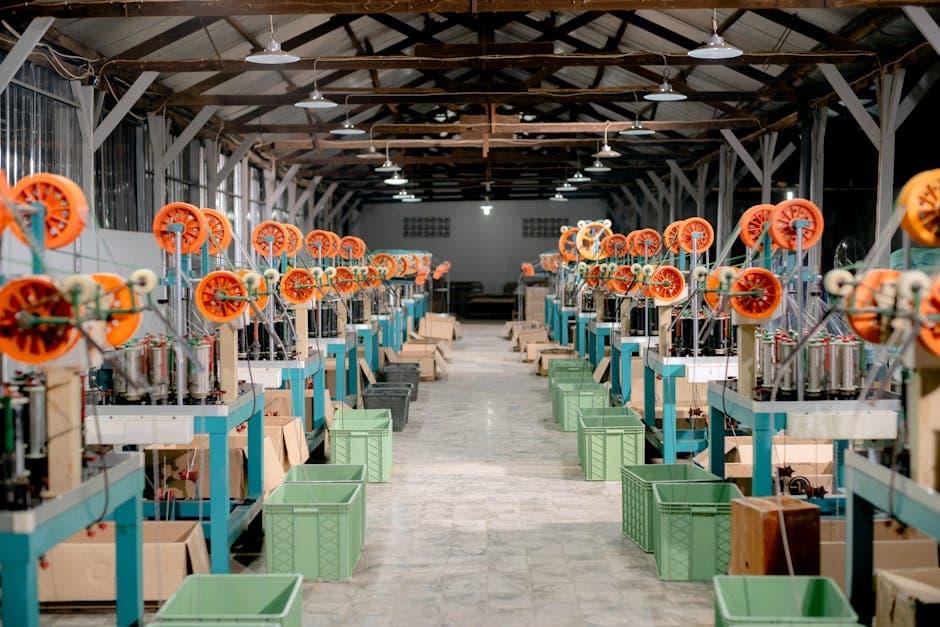

A manufacturing cell is a dedicated group of machines and operators organized to produce a product family — a set of parts or products that share similar routings, materials, and operation types. The classic layout is U-shaped: machines arranged so that one operator can reach multiple stations and move parts through the sequence without walking across a large shop floor.
The defining characteristic is dedication. In a functional layout, an engine lathe serves any job that requires turning, regardless of what product family that job belongs to. In a cellular layout, the lathe in Cell 1 serves only the product family Cell 1 is designed for. This dedication is what makes lean tools like takt time and one-piece flow applicable within the cell.
What a cell is not is simply a cluster of machines grouped physically. Physical proximity without routing dedication doesn't change the scheduling problem. If the machines in a "cell" still accept any job from anywhere in the shop, you have a U-shaped functional area — the scheduling logic is unchanged, and the lean benefits don't materialize.
How Scheduling Within a Cell Differs
Functional Layout: Priority-Based Competition
In a functional layout, every machine is a shared resource. Jobs from all product lines and customers compete for access to each machine based on priority rules (earliest due date, shortest processing time, customer ranking, expedite flags). The scheduler's job is to sequence that competition in a way that meets the most due dates while keeping utilization high.
This creates inherent complexity: the schedule for Machine A depends on what Machine B is doing because jobs move between both. A downstream bottleneck on one machine type creates invisible queues everywhere upstream. The scheduler must model the entire shop simultaneously.
Cellular Layout: Takt-Driven Flow
In a dedicated cell, scheduling changes character. Because the cell handles only one product family, and that family's parts all follow the same (or very similar) routing through the cell's machines, the question shifts from "who gets the machine next" to "is the cell running at the right rate to meet demand?"
The cell's takt time — available cell time divided by product family demand — becomes the governing rhythm. Each station in the cell should complete its operation within takt. If one station takes longer than takt, it's the bottleneck; you address it with operator cross-training, tooling improvements, or upstream pacing adjustments. If all stations complete within takt, the cell delivers on time without expediting.
Within the cell, job sequencing is determined by arrival sequence and family mix — not by cross-shop priority. A job entered into the cell's queue follows the cell's routing; the scheduler doesn't need to continuously re-evaluate priorities against shop-wide competition. This is a genuine simplification: a cell with a well-matched takt rate is largely self-scheduling.
Where Complexity Moves
Converting to cells doesn't eliminate scheduling complexity — it relocates it. Two new scheduling challenges emerge:
1. Loading the cell correctly. Someone must decide how many jobs to release to the cell per day, and in what sequence, to keep the cell at or near its takt rate without overloading or starving it. This is the cell pacing problem, and it requires a capacity model of the cell's throughput rate against the demand pipeline.
2. Scheduling between cells. Jobs that require processing in multiple cells — or that move from a cell to a shared resource and back — create inter-cell dependencies that require shop-wide visibility. This is often more complex than the original functional scheduling problem, because now there are multiple takt-driven sub-systems that must hand off work coherently.
Scheduling Cell-to-Cell: The Interface Problem
When a product family's routing requires operations in two different cells — for example, machining in Cell 1 and assembly in Cell 2 — the interface between those cells becomes a scheduling constraint that neither cell can resolve independently.
The practical tools for managing this interface:
Buffer stock between cells. A small standard WIP quantity at the entrance to Cell 2 smooths arrival variability from Cell 1. If Cell 1 is slightly ahead or behind its takt on any given day, Cell 2's buffer absorbs the variation without starving Cell 2 or causing Cell 1 to wait. The buffer size should be calculated based on arrival variability, not set arbitrarily.
Finite capacity modeling across cells. A scheduling model that represents each cell as a single capacity resource with its own throughput rate allows planners to see loading across all cells simultaneously. If Cell 2 has 3 days of backlog and Cell 1 is feeding it at 20% above the buffer replenishment rate, the problem is visible before it becomes a delivery failure.
Sequencing discipline at the cell entrance. The order in which jobs enter a cell affects which customer commitments are met. Even in a takt-driven cell, the scheduler must sequence the arrival queue by due date priority — the cell's internal logic handles the rest, but the external input must be managed.
RMDB handles this by modeling each cell as a logical resource group with defined capacity, allowing planners to view cell loading, set WIP caps at each cell entrance, and track inter-cell job movement through a unified schedule view rather than managing each cell in isolation.
Dedicated vs. Shared Resources: The Critical Design Decision
The most consequential design decision in cellular manufacturing is determining which resources become dedicated to a cell and which remain shared across the shop.
The Case for Dedication
Dedication enables the scheduling simplicity described above — takt-driven flow, reduced priority conflict, simplified planning. It also enables physical layout optimization (U-shape, short material travel distances) and builds operator expertise in a specific product family, which improves quality and setup time.
The Case for Shared Resources
Shared resources maintain utilization efficiency. A $400,000 CNC machining center that runs at 85% utilization on jobs from multiple product families should not be dedicated to a single cell that would keep it at 40% utilization. The cell would gain scheduling simplicity at the cost of asset efficiency that doesn't justify itself economically.
The Decision Threshold
The practical decision threshold is utilization by product family. If a machine type runs at more than 60–70% utilization specifically on jobs belonging to a single product family, it's a strong candidate for cell dedication. Below that threshold, the machine is better kept in the general shop, and the cell uses it as a shared resource — accepting some scheduling complexity to preserve utilization.
The exception is for equipment where physical proximity to the cell's other operations creates quality or handling benefits that outweigh utilization inefficiency. A CMM (coordinate measuring machine) might be justified in a precision machining cell even at 40% utilization because first-piece inspection must happen immediately after machining to catch problems before they propagate.
Cross-Training Operators Within the Cell
One of the most powerful features of cellular manufacturing from a scheduling standpoint is operator cross-training: qualifying each cell operator to run multiple stations in the cell.
Cross-training provides scheduling flexibility within the cell. When demand increases, a cross-trained operator can shift to the bottleneck station while another operator covers their primary station. When demand decreases, the cell can run with fewer operators — one person covers multiple stations rather than standing idle at a single station with no work.
In scheduling terms, cross-training converts operators from fixed resources (one person, one machine) to flexible resources (one person, multiple machines based on current cell loading). This flexibility is what allows a cell to absorb demand variability without collapsing its takt-driven flow.
The scheduling implication is that the model must track operator qualification — which operators are qualified on which stations — not just machine capacity. This is why RMDB's resource model supports multi-skill operator profiles: scheduling flexibility within a cell depends on knowing what each operator can do, not just how many operators are available.
Managing Demand Variability in a Fixed-Capacity Cell
Cells are designed for a specific demand rate. When actual demand for the product family deviates significantly from that design rate — either because of seasonal patterns, project wins, or market shifts — the cell faces a capacity mismatch.
When demand exceeds cell capacity: First response is overtime and cross-training to flex headcount. Second response is subcontracting specific operations that have external capacity available. Third response is routing overflow jobs to the general-purpose area, accepting the scheduling overhead of functional layout for those units. Rarely should you permanently size the cell to peak demand — you'd have chronic underutilization at normal demand.
When demand falls below cell capacity: Cross-training allows operators to shift to other cells or general-purpose work. If the decline is structural (loss of a major customer, product end-of-life), the cell design should be revisited and resources may need to be converted back to shared.
The coefficient of variation test: Before building a cell, calculate the coefficient of variation (CV = standard deviation / mean) of weekly demand for the target product family. CV below 0.3 is ideal for cell scheduling. CV above 0.6 indicates demand is too volatile for a tightly takt-driven cell — you'll need larger buffers or more flexible resource assignment than a standard cell design provides.
Converting from Functional to Cellular: A Decision Framework
For a plant manager evaluating whether to convert a functional area to cells, the decision framework follows five questions:
- Volume: Are there product families with enough volume to keep dedicated equipment busy? (60%+ utilization threshold)
- Routing similarity: Do the parts in each candidate family share at least 70% of their operation types and sequence?
- Setup compatibility: Are setups short enough (or can SMED reduce them enough) that changeover within the cell is manageable?
- Demand stability: Is demand for the family stable enough for takt-based planning? (CV < 0.5)
- Operator availability: Do you have — or can you build — operators capable of cross-training across the cell's stations?
If the answer is yes to all five, a cell is a clear win. If one or two are marginal, the cell can work with design modifications. If three or more are no, the product family is better served by functional layout with good finite capacity scheduling.
The most common mistake is converting based on volume alone, without analyzing routing similarity or demand stability. A cell built around a product family with highly variable demand and inconsistent routings will have worse scheduling outcomes than a well-run functional area — because you've given up the flexibility of shared resources without getting the simplicity of true takt-driven flow.
The Scheduling Payoff of Getting Cellular Right
When cellular manufacturing is implemented correctly — dedicated resources, matched takt rate, cross-trained operators, proper inter-cell modeling — the scheduling benefits are substantial:
- Lead time reduction of 40–70% for products running through the cell (queue time at shared machines eliminated)
- Schedule adherence improvement (takt-driven flow is inherently predictable)
- Reduced scheduler workload (cell handles its own internal sequencing; scheduler manages cell loading and inter-cell interfaces only)
- Faster quality feedback (defects caught within the cell before they move downstream)
These benefits don't come automatically from drawing U-shapes on a floor plan. They come from aligning the scheduling model with the physical layout — treating cells as capacity units, modeling inter-cell interfaces explicitly, and using operator qualification data to flex resources intelligently.
Cellular manufacturing scheduling governs a dedicated group of machines and operators focused on a product family. Unlike functional scheduling (where jobs compete across shared machines by priority), cell scheduling is takt-driven: every job entering the cell follows the same routing, and the cell's capacity is matched to the demand rate of that product family. The scheduling problem simplifies from "who gets the machine next" to "is the cell loaded above or below its takt rate."
Inter-cell scheduling is the hardest part of cellular manufacturing. When a job completes in Cell A and needs processing in Cell B, it enters Cell B's queue just like any other arrival. Cells are capacity-constrained independently. The key tool is a finite capacity model that represents each cell as a single logical resource with its own queue and throughput rate, so planners can see loading across all cells simultaneously and spot inter-cell bottlenecks before they cause late deliveries.
Dedicate when utilization justifies it. A machine used more than 60–70% of its capacity by jobs in a single product family is a strong candidate for cell dedication. Below that threshold, the machine is better kept shared — you'd be dedicating capacity that sits idle when the product family demand drops. The exception is for very expensive or specialized equipment where the physical collocation benefit of the cell layout outweighs the utilization inefficiency.
Three mechanisms: cross-training operators to flex headcount in response to demand swings, using buffer stock (standard WIP levels) at the cell entrance to smooth arrival variability, and temporarily routing overflow jobs to a general-purpose area. The key insight is that cells are most effective when demand variability for the product family is modest — typically a coefficient of variation below 0.5. Highly volatile product families are poor cell candidates regardless of volume.
Ready to model your cellular layout in a finite capacity scheduler? Contact User Solutions to see how RMDB represents cells, shared resources, and inter-cell interfaces in a single unified schedule. Trusted by GE, Cummins, BAE Systems, and leading manufacturers for 35+ years.
For more lean manufacturing fundamentals, see our lean manufacturing glossary, just-in-time manufacturing guide, and post on lean manufacturing in job shops.
Expert Q&A: Deep Dive
Q: We're converting our functional shop to cells. How do we determine which part families belong in each cell?
A: Use a Production Flow Analysis (PFA) or Group Technology analysis. Cluster your parts by routing similarity — parts that visit the same sequence of operation types belong in the same family. The classic tool is a machine-part incidence matrix: rows are part numbers, columns are machine types, cells (values) indicate whether that part visits that machine. Cluster the matrix to reveal natural groupings. In 35 years of working with shops through this process, we consistently find that 70–80% of parts cluster into 3–6 families with clean routings, while 20–30% are true outliers that stay in a general-purpose area.
Q: How does RMDB model a cellular layout differently from a functional layout?
A: In RMDB, a cell is represented as a set of resource nodes connected by routing sequences specific to the cell's product family. The scheduler can enforce that jobs belonging to the family route through the cell's resources in the defined sequence, while jobs outside the family are blocked from those resources (or allowed with explicit override). This gives planners visibility into cell utilization independently from shop-wide utilization — you can see that Cell 1 is at 95% while Cell 2 is at 60% and adjust accordingly. The cell model also makes cross-training visible: when an operator is qualified on multiple stations within the cell, the scheduler can flex that operator's assignment to balance the cell's internal flow.
Frequently Asked Questions
Ready to Transform Your Production Scheduling?
User Solutions has been helping manufacturers optimize their production schedules for over 35 years. One-time license, 5-day implementation.

User Solutions Team
Manufacturing Software Experts
User Solutions has been developing production planning and scheduling software for manufacturers since 1991. Our team combines 35+ years of manufacturing software expertise with deep industry knowledge to help factories optimize their operations.
Share this article
Related Articles

Andon-Triggered Rescheduling: How Real-Time Machine Alerts Should Change Your Production Schedule
Andon alerts signal a production problem — but most plants stop at the alert. Learn the complete andon-to-reschedule workflow that protects delivery commitments when things go wrong.

Can You Do Lean Manufacturing in a Job Shop? Yes — Here's How to Adapt It
Lean manufacturing works in job shops — with the right adaptations. Learn which principles transfer directly and which need modification for high-mix, low-volume production.

Manufacturing SOPs: How to Write, Implement, and Maintain Standard Operating Procedures
Learn how to create effective manufacturing SOPs that reduce defects, improve training time, and connect to production scheduling for consistent throughput.
